Project No. RW943; Project File No. S5055
Location

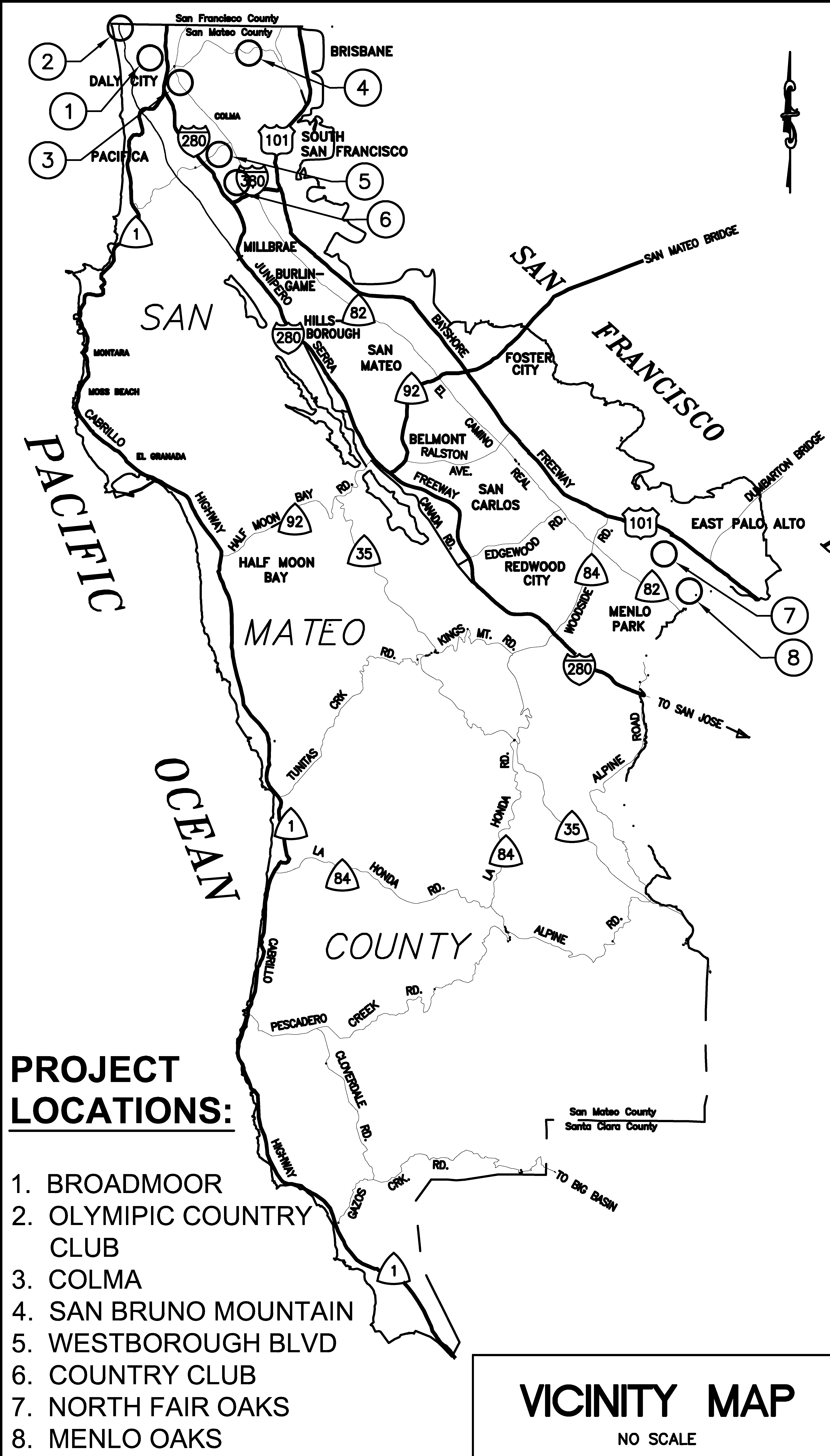

Broadmoor Village, Olympic Way, Colma, Guadalupe Canyon Parkway, Westborough Boulevard, Country Club, North Fair Oaks, Menlo Oaks
About the Project
The 2022 Pavement Preservation Project involves pavement repair, asphalt rubber cape seal, micro-surfacing, slurry seal, and restriping of various streets in the unincoprated areas of San Mateo County.
Public Works Contact
Carter Choi
Senior Engineer
cchoi@smcgov.org
650-363-4100
Contractor
Pavement Coatings Co. (PCC)
UPDATES
- June 2022: Project is out to bid, advertised as of 6/30/22
- July 2022: BOS had Awarded the Project Contract to PCC on 7/26/22
- August 2022: County-PCC Pre-Construction meeting on 8/23/22 and Notice to Proceed issued on 8/31/22
- September 2022: Construction began 9/8/2022 (Expected completion date 11/18/22)
-
October 2022 : Percent of Time Elapsed 75%, Percent of Contract Complete 85%
-
November 2022 : Percent of Time Elapsed 90%, Percent of Contract Complete 91%
-
December 2022 : Percent of Time Elapsed 95%, Percent of Contract Complete 91%
-
January 2023 : Construction completed on January 26, 2023.
Schedule
Attached schedules are subject to change based on weather and other unforeseen conditions. The schedule will be updated, as needed.
